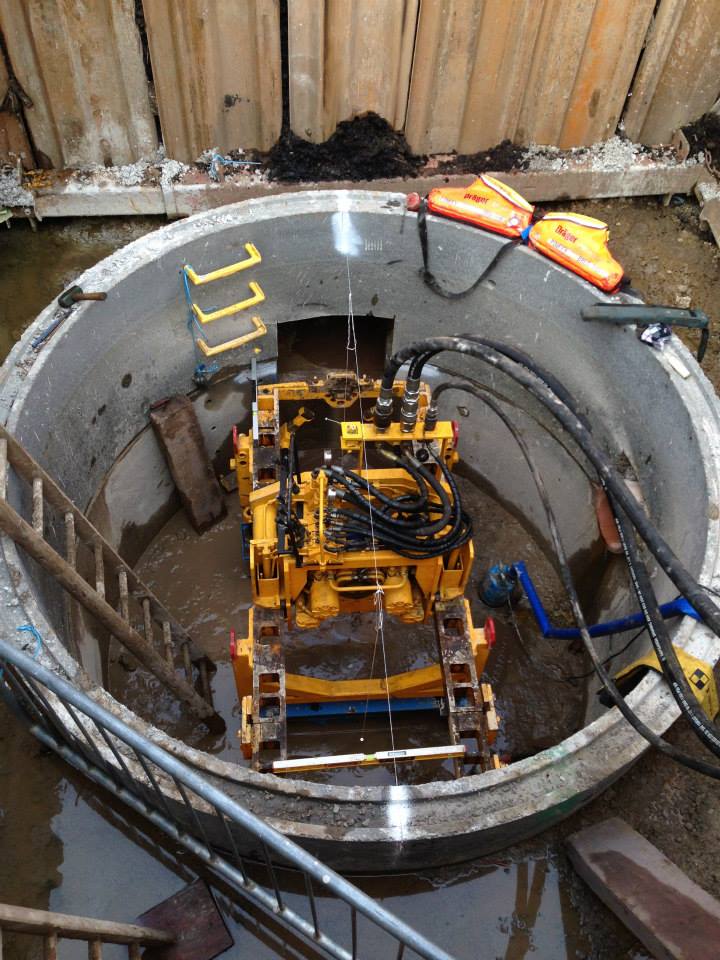

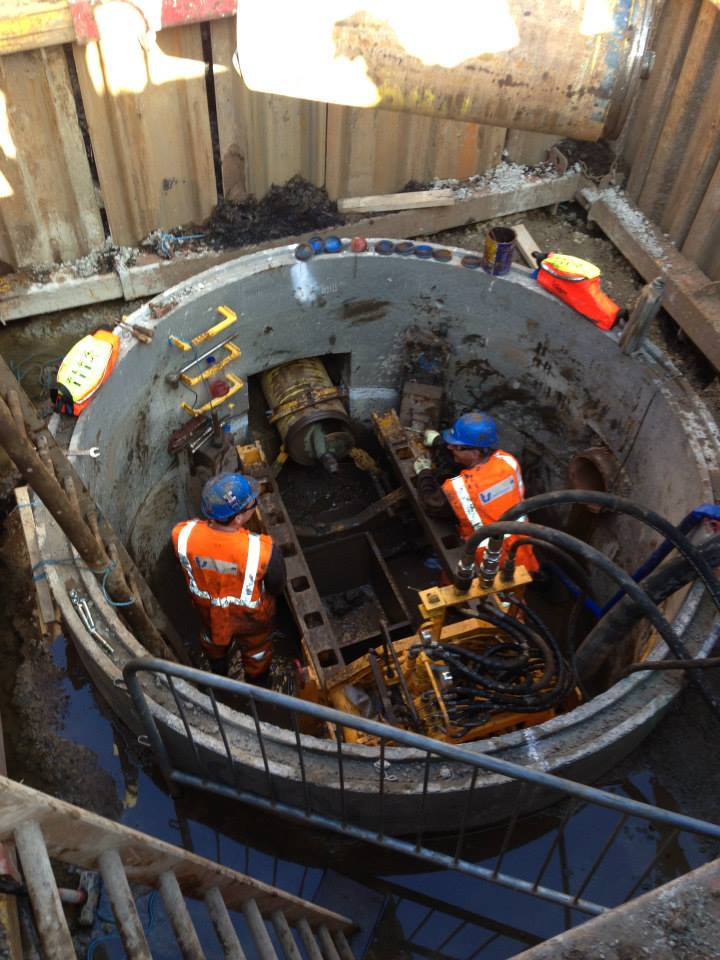

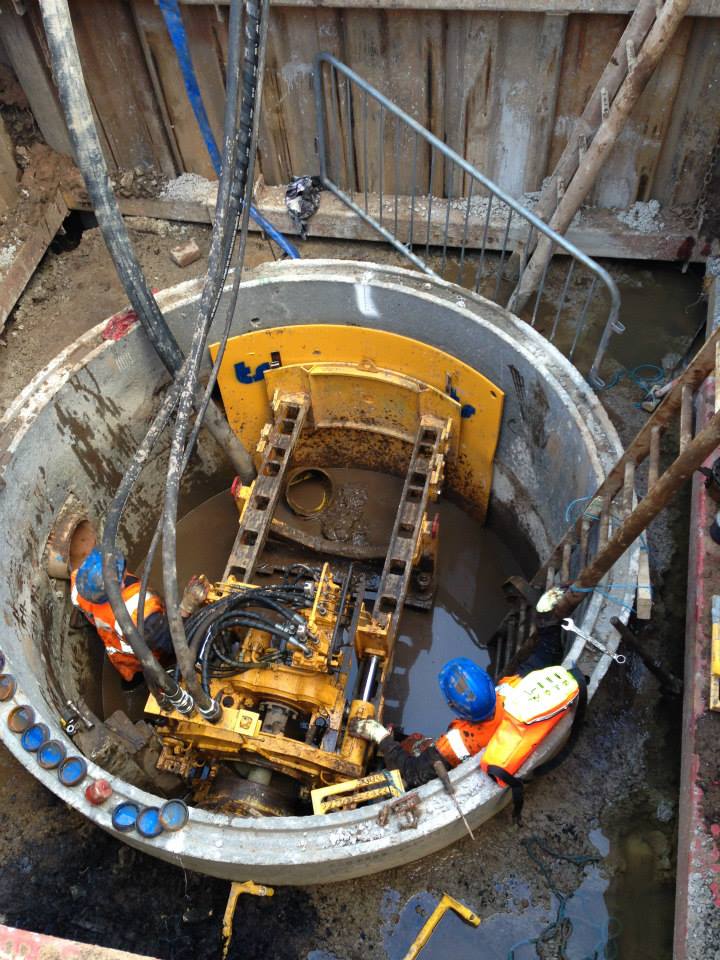

Trenchless Solutions Ltd was asked to look at a 50m under track crossing (UTX) in North Wales main contractor was Amco rail division, after an initial site visit TSL offered a Guided Auger Bore trenchless technique. TSL mobilised to site on Monday afternoon, set up and completed the pilot operation on Tuesday, started the installation of casings and augers on Wednesday completing on Thursday and also pulling augers, completing the Jacking of DN300 drainage pipe by lunchtime Friday. Great effort by our lads James, Billy and Mark.
